2025 Kensington fiberized Slurry Seal and Overlays

Project Overview

The work to be done generally consists of placing two types of surface treatments on various roads in Kensington area: a type II fiberized slurry seal, or cold plane and overlay with hot mix asphalt (HMA), Including Clark Road in El Sobrante. Work will involve surface preparation, including weed spray, crack sealing, pavement failure repair, edge grinding, removal of existing thermoplastic stripes and pavement markings, removal of existing curb and sidewalk, and placing concrete curb ramps in compliance with the American with Disabilities Act, setting survey monuments, and placement of thermoplastic striping and pavement markings.

2025 Kensington fiberized Slurry Seal and Overlays | Contra Costa County, CA Official Website

Mountain landscape under a blue sky with "Contra Costa Public Works" logo in the top left corner.

Road Closure Updates

10/01/2025

🚧 Road Work Update – Slurry Seal Project Nearing Completion 🚧

Heads up, Kensington! The slurry seal phase of the road improvement project is wrapping up this week. Final work will take place Thursday 10/2 and Friday 10/3 on Beloit, Trinity, and Kenyon streets.

✅ One-way traffic access will be maintained to ensure connectivity between Grizzly Peak Blvd, Arlington Ave, and the elementary school.

👷 Crews will also be performing touch-ups throughout Kensington, which may cause minor, mobile disruptions.

🏫 If you're dropping off or picking up kids at the elementary school, please plan ahead—school staff have been notified to help keep things smooth.

🧹 After slurry work is done, expect street sweeping to clear leftover materials. Final striping will begin next week with minimal traffic impact.

Thanks for your patience and support as we improve our roads!

📍 See the attached map for affected areas.

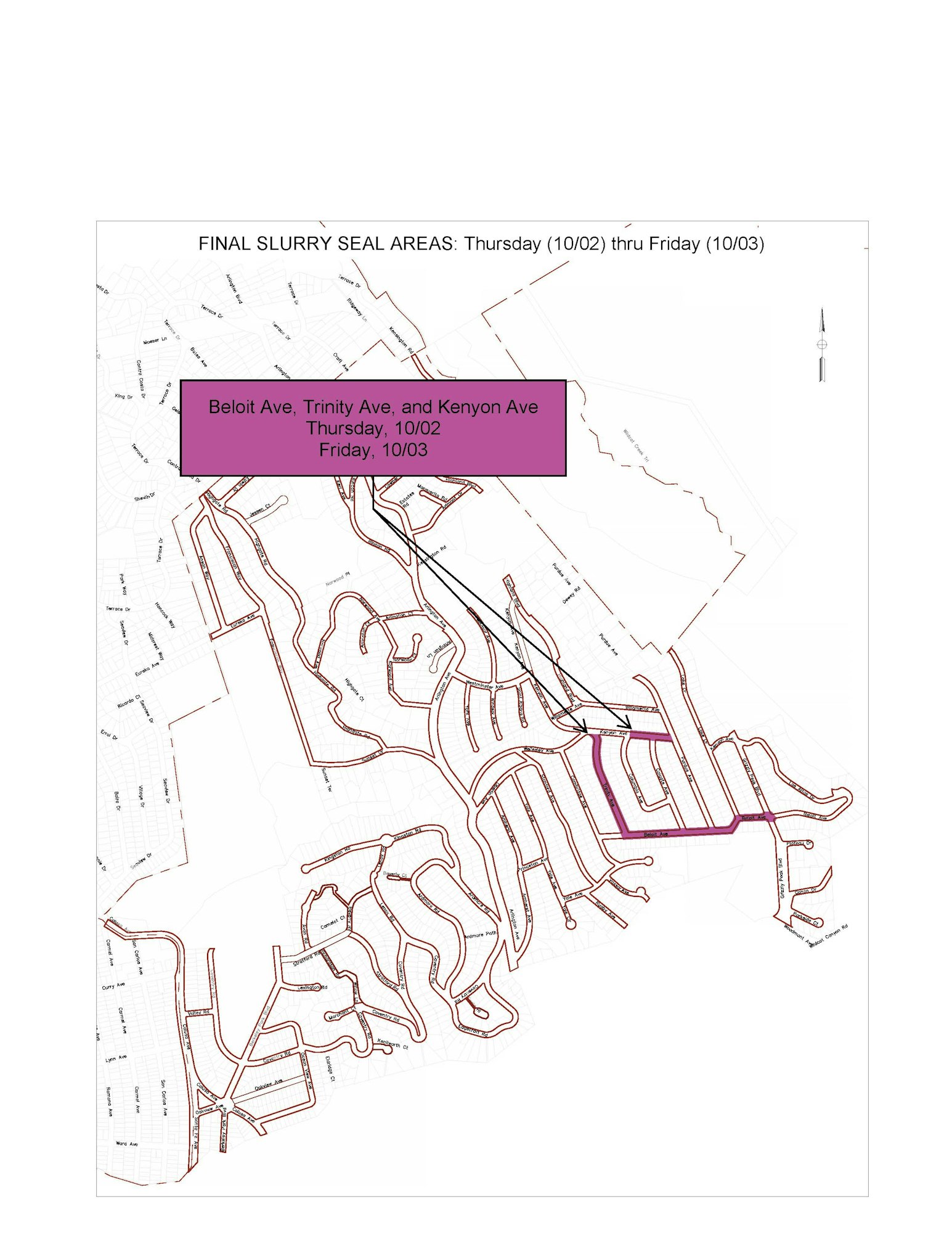

Map highlighting slurry seal areas for Beloit Ave, Trinity Ave, Kenyon Ave on 10/02-10/03.

9/25/2025

🚧 Slurry Seal Project Update – Kensington Community 🚧

We’ve received an updated schedule from Contra Costa County Public Works regarding the Pavement Coating Company (PCC) slurry seal work in our area. Due to light rain earlier this week and some production challenges, the project timeline has shifted slightly.

🔹 New Completion Date: Tuesday, September 30
🔹 Arlington Avenue: Remaining portion scheduled for completion on Monday, September 29
🔹 Touch-Up Work: Monday and Tuesday will also be used to address touch-ups and any streets missed this week

We appreciate your continued patience and understanding as this important work wraps up. If there are any further changes, we’ll keep you posted.

Map showing slurry seal schedule from 09/25 to 09/30 with different colored routes marked.
Street maintenance schedule with dates, street names, and area measurements.

9/19/2025

🚧 Kensington Road Work Update: Slurry Seal Schedule (Sept. 19–24, 2025)

The county is nearing the final stages of the 2025 Kensington Fiberized Slurry Seal and Overlays Project, and we appreciate your continued patience and support.

📅 Updated Work Schedule

Contra Costa County Public Works subcontractors will be performing slurry seal operations from Friday, September 19 through Wednesday, September 24. This includes previously scheduled areas and streets that were missed earlier in the project. These will be addressed on Tuesday and Wednesday, September 23–24.

🚗 Traffic Advisory for Arlington Avenue – Monday, September 22

  • Slurry seal work is scheduled for Arlington Avenue on Monday, September 22.
  • Expect one-way traffic control, similar to the setup during paving operations in August.
  • Slurry seal cures faster than asphalt, so closures will be shorter and less disruptive.
  • Traffic control crews will be on-site to manage flow and minimize delays, but some traffic impacts are unavoidable.

🧹 Cleanup & Rework

  • Crews will revisit previously sealed areas early next week to:
    • Address spots missed due to parked vehicles.
    • Clean up any excess slurry in curb and gutter sections.

🏫 Coordination with Kensington Hilltop Elementary

We’ve shared the updated schedule and map with the school administration to ensure minimal disruption to students and staff.

Map detailing slurry seal schedules with color-coded roads from 09/19 to 09/24.
A schedule lists street names, directions, and areas in yards for each day from 9/19/2025 to 9/24/2025, with daily totals.

9/12/25

  • Project Stage: The project has entered the slurry seal stage, which is the second-to-last major phase. The final phase will involve signage and striping.
  • Schedule:
    • Slurry seal work is scheduled for September 15–19.
    • Arlington Avenue is scheduled for slurry seal work during the week of September 22. This will involve 1-way traffic control, similar to what was done the week of August 11.
  • Street Closures:
    • Slurry seal work requires complete street closures for certain periods before traffic can resume.
    • This is different from crack seal work, which typically allows more traffic flexibility.
  • School Coordination:
    • Work near Kensington Hilltop Elementary School will be limited to ensure continuous access for parents and teachers during drop-off and pick-up times.

Download the detailed plans below:

Pavement Coating Co. Slurry Seal Map Schedule - 09.12.25.pdf

9/9/2025

The Kensington Slurry and Overlay project has provided a treatment schedule. We have posted their proposed construction schedule below using the images provided.  Slurry Seal should start on September 11 and run through September 22nd.

Roads will be closed for 4-6 hours. Residents can contact Tricia Baxter, Resident Engineer, for any specific arrangements during street construction. She can be reached via email at Tricia.Baxter@consorpmcm.com

Map of Kensington detailing fiberized slurry seal construction schedule from 09/18 to 09/22, highlighting affected streets.
Slurry seal construction schedule for Kensington 2025 with street details for 09/11 and 09/12. Includes street names, segments, and areas.

Schedule for Kensington slurry seal work from 09/15 to 09/17, listing streets, start and end points, and area in yards.
Kensington slurry seal construction schedule for 09/18, 09/19, and 09/22, listing streets, start and end points, and area in yards.

9/3/2025

Please see attached updated work for the County showing the schedule through Tuesday 9/09. Work on Kenyon Ave is expected to begin on 9/5/25 and the school detour plan is below.

2025.09.03 GBI Work Plan & Sequence.pdf2025.08.21 Kenyon Ave & School Detour Plan.pdf

8/26/2025

Work on Kenyon Ave is expected to begin on 8/28/25. Please see the county's work sequence in the document below. The school detour plan posted on 08/21/25 will still be in effect.

2025.08.26 GBI Work Plan Sequence.pdf

8/21/2025

Contra Costa County Public Works will be closing Kenyon Avenue on 08/28/2025.  The attached county maps show morning and afternoon alternate pickup routes for Kensington Elementary School.   Please see the map below.

2025.08.21 Kenyon Ave & School Detour Plan.pdf

This essential work is being performed to seal and strengthen Kensington’s roadways, especially ahead of the wet season when water infiltration can compromise the structural integrity of our roads and surrounding land.

- Please plan alternate routes during this time. Traffic mitigation measures are being evaluated to reduce delays and improve flow for all motorists.
- We ask for your patience and cooperation with road crews working diligently to improve our community’s infrastructure.
- Stay Updated: The Kensington Police Department will post weekly updates on construction locations to Nixle.
